Large-Scale Project Controls Through Schedule Consolidation

Share on Linkedin

The MIGSO-PCUBED Paris team shares a case study of schedule consolidation and integration on a large-scale project.

Table of Contents

Our client

The Grand Paris Express is a project for a public transport network in the Paris region that will enable suburb-to-suburb travel without passing through Paris. It involves the creation of 4 new automatic metro lines, lines 15, 16, 17 and 18, and the extension of an existing line, line 14, between 2024 and 2031.

The Société du Grand Paris, a public establishment created in 2010, is responsible for designing and building the Grand Paris Express transport network, which is currently the largest rail infrastructure project in Europe.

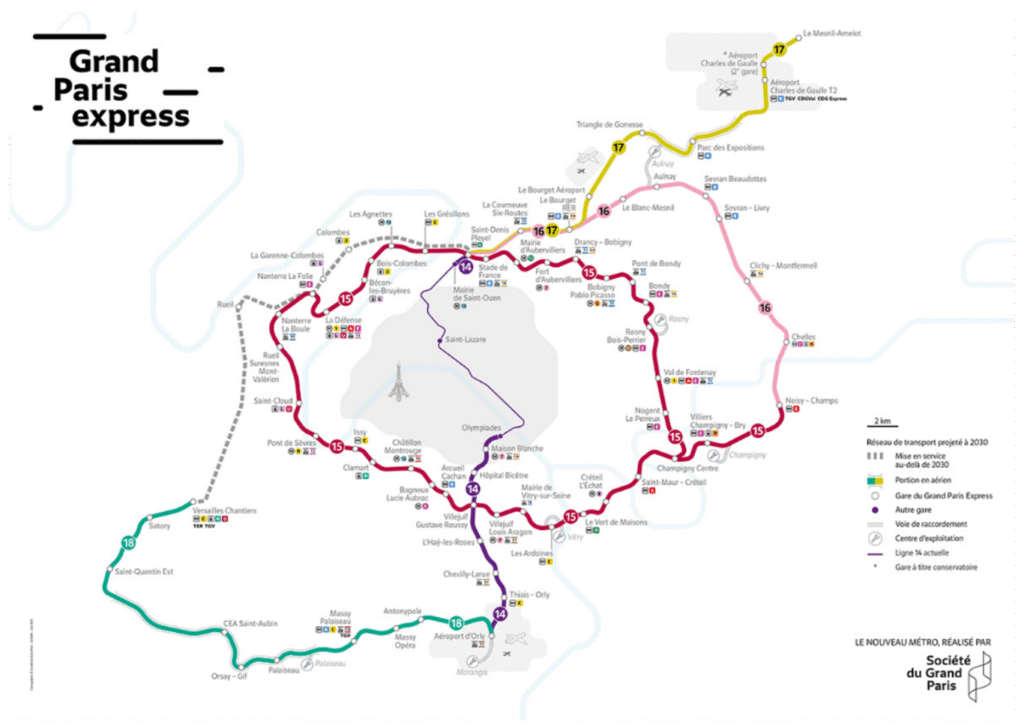

Le réseau de transport du Grand Paris Express fait par la Société du Grand Paris

The mission

As part of this assignment, our MIGSO-PCUBED team is involved in project controls for the consolidation of existing schedules, and more specifically in making the governing schedules more reliable.

Our methodology

The first step in making governing schedules more reliable was to carry out an audit of existing schedules. There are 7 types of schedules within the company, which can be divided into 2 categories:

  • Transversal schedules: macro-planning by line, administrative procedures, purchasing and design studies, testing.
  • Structural schedules: stations, tunnels, and connecting structures.

Connecting Structures are structures linking the tunnel to the surface. They serve as emergency access for firefighters, evacuation, and ventilation. They are generally placed every 800m.

Given the number of schedules to be audited (around 125), we took a sample of these schedules (around 30) and checked their completeness against the baseline, the document outlining all information that must be included.

Below is an example of a line’s station and connecting structure schedules:

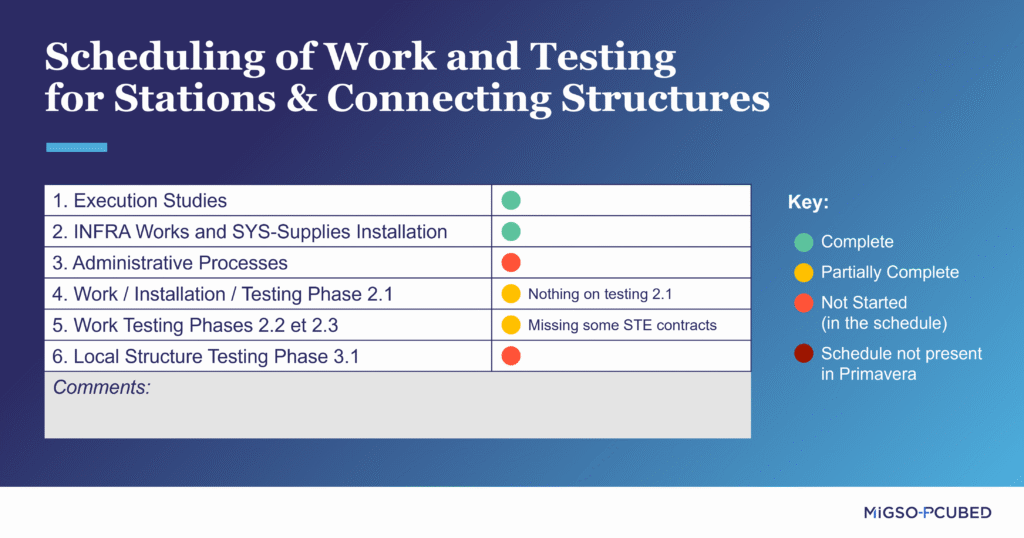

Scheduling of Work and Testing for Stations & Connecting Structures

As the project progressed, and following discussions with the customer’s scheduling teams, the need arose for a standard sequence on the process of opening a standard Public Access Site.

To create this sequence, the MIGSO-PCUBED team took a flow chart drawn up by the customer’s management and integrated it into the Primavera P6 scheduling tool. Then, to determine typical durations, it used the example of the 1st opening of a current station. The typical sequence thus includes all the stages and documents required from acceptance of the work to the opening of the station.

The initialization of this standard sequence is based on a retro-planning logic, taking the opening date of the station as a reference.

Therefore, we started from the station opening date, to which we attached the tasks in the sequence with the latest scheduled date. There are two main phases to this sequence: “acceptance of work” and “process for compliance and for opening”. The “acceptance of work” phase will be the one that links the standard sequence to the work schedules.

According to the PMI reference system, task sequencing precedes scheduling, which includes the deadlines for each task. By working backwards in the schedule, from the expected station opening date, it is then easy to create the schedule using the sequences and deadlines for each task.

WBS methodology reminder > A sequence of tasks and the resulting schedule are implemented based on the Work Breakdown Structure (WBS).

The ultimate goal is to remove the need to schedule work as late as possible in order to match the actual progress of work at each station. To this end, in the coming months, the standard sequence will be integrated into the governing schedules, so that it can be reworked with all the stakeholders involved to consolidate the “acceptance of work” phase, which will determine the rest of the task sequencing.

The benefits for our client

Engagements for Project Controls are often delicate, as they take place in a context of activities already launched with committed stakeholders. Developing project management processes and tools during this phase requires great adaptability, insight, and a sense of perspective.

MIGSO-PCUBED’s involvement was necessary and supported by the company’s Setup & Control as well as Scheduling teams: the WBS was not complete, and some activities could not have been anticipated, thus increasing operational urgency as well as technical, delivery, and certification risks.

After all, scheduling is not just about meeting the client’s expected requirements, although that is the very essence of project management. Scheduling also allows for working in a calm environment, in which quality assurance is provided.

To go further, MIGSO-PCUBED has proposed a “standard sequence” to facilitate and harmonize all schedules (including both internal and supplier schedules) for the “Grand Paris” project, thus strengthening coordination efforts.

This article was originally written in French by Aurélien Chardonneau, Cédric Laurent, and Jonathan Rinfray with contributions from the MIGSO-PCUBED consultant team working for the Société du Grand Paris.
